Named after the village of Tugaske, this project will be developed on Gensource’s wholly-owned Vanguard Area. An environmental assessment approval is already complete. With strong financial partners with lenders KfW IPEX-Bank & Société Générale underwriting the Senior Debt Facility, the Tugaske Project is ready to proceed to construction upon securing last mile project financing.
Tugaske Project Highlights
![VISION PLANTS (1) VISION PLANTS (1)](https://gensourcepotash.ca/wp-content/uploads/2020/07/VISION-PLANTS-1-80x80.png)
Feasibility Study
Complete
![SUSTAINABLE SUSTAINABLE](https://gensourcepotash.ca/wp-content/uploads/2020/07/SUSTAINABLE-1-80x80.png)
Environmental Assessment
Complete
![PARTNERSHIPS PARTNERSHIPS](https://gensourcepotash.ca/wp-content/uploads/2020/07/PARTNERSHIPS-120x80.png)
Plant Site Land Option
Agreement in Place
![BACKHOE BACKHOE](https://gensourcepotash.ca/wp-content/uploads/2020/07/BACKHOE-94x80.png)
A “Shovel Ready”
Project
![FINANCE UP FINANCE UP](https://gensourcepotash.ca/wp-content/uploads/2020/07/FINANCE-UP-80x80.png)
10-Year Offtake with
Helm AG Fertilizers
![TEAM TEAM](https://gensourcepotash.ca/wp-content/uploads/2020/07/TEAM-74x80.png)
Open Capital Structure to Complete Financing of Tugaske Project
![FINANCING CYCLE FINANCING CYCLE](https://gensourcepotash.ca/wp-content/uploads/2020/07/FINANCING-CYCLE-80x80.png)
CAD$ 280 Million
Debt Financing in Progress
This greenfield construction project requires minimal footprint and is near key infrastructure such as highway & rail access, natural gas, power, water, and labour.
Similar to other Gensource module designs, the Tugaske Project will produce a minimum of 250,000 tonnes of muriate of potash (MOP) per year. HELM Fertilizers Corp, a US-based subsidiary of HELM AG, has agreed to purchase 100% of the annual production from the Tugaske Project and market directly to its customers using its own infrastructure for at least the first 10 years.
Tugaske will be one of the lowest cost producers in the industry

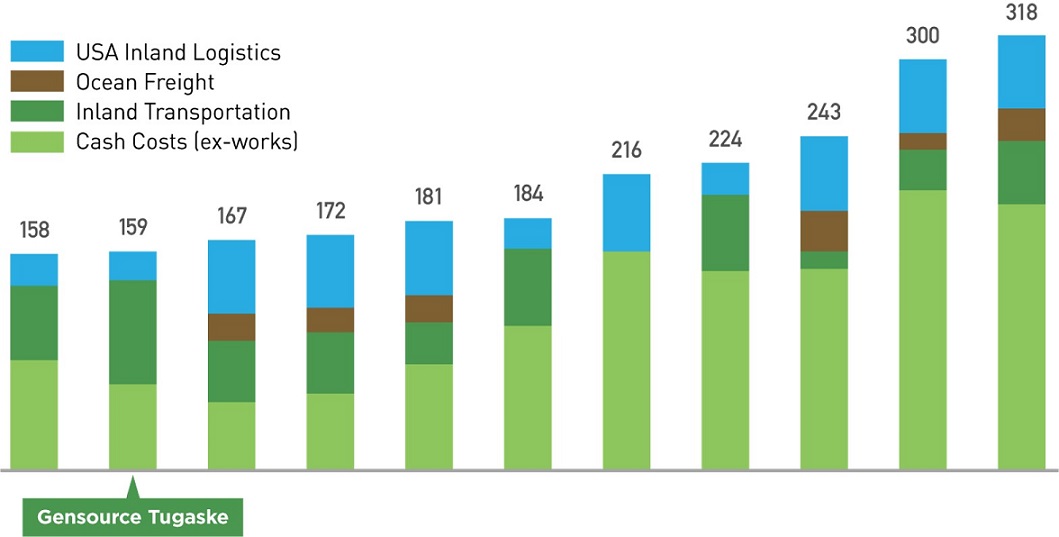

Average Retail Potash Price (Feb 2023) – US$742/tonne
![](https://gensourcepotash.ca/wp-content/uploads/2023/04/low-cost2.jpg)

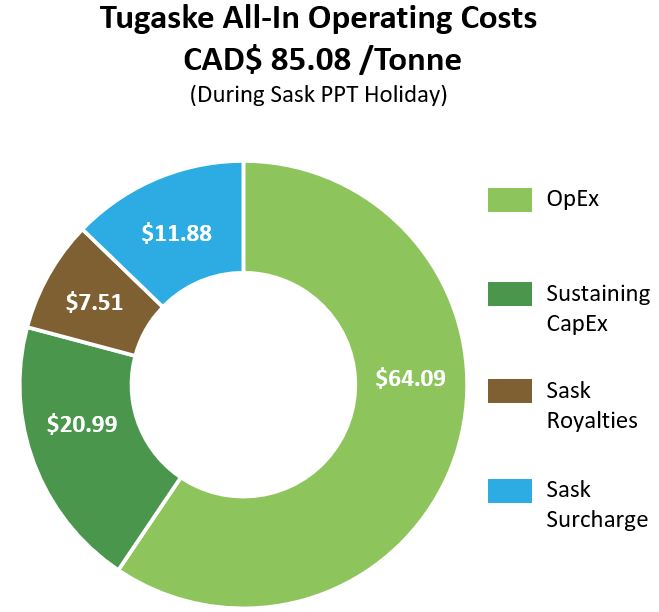

Tugaske All-In Operating Costs CAD$ 85.08 /Tonne (During Sask PPT Holiday)
Source: NI 43-101 Technical Report Summarizing the Tugaske Project, Saskatchewan 2021. Report available on SEDAR.
![](https://gensourcepotash.ca/wp-content/uploads/2021/11/operating-costs-chart2.jpg)

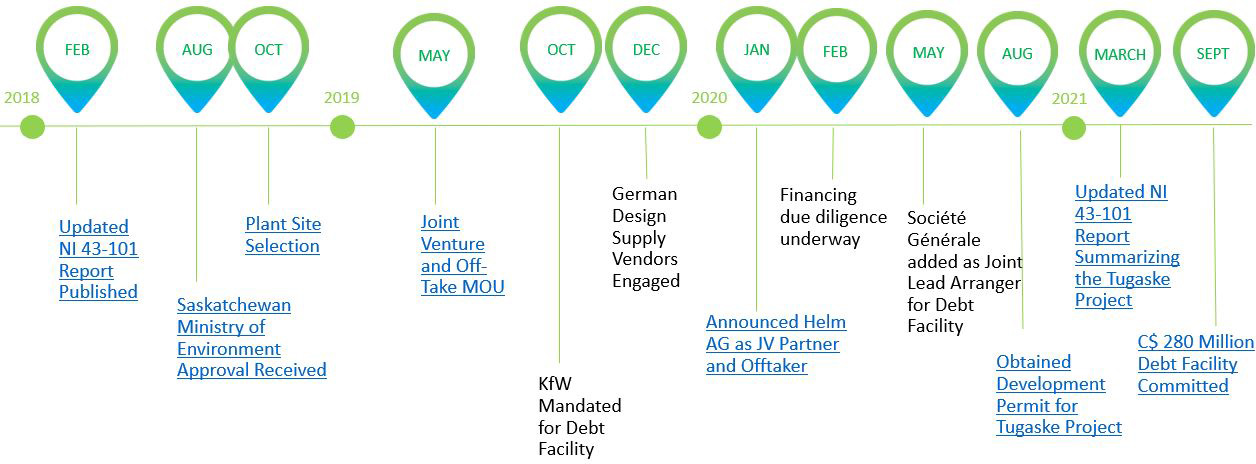

Tugaske Project’s major milestones.
![](https://gensourcepotash.ca/wp-content/uploads/2021/11/timeline.jpg)
